Magrios / Knowledge / Enterprise / Pilot-to-contract: what a 30-day intelligence-to

Pilot-to-contract: what a 30-day intelligence-tool pilot must prove

Guide · Enterprise · 4 min read · last verified 2026-08-11

Reviewed before publication Editorial board Independent commercial review
In shortThe four things a 30-day pilot can genuinely prove, a week-by-week design with a day-zero test, and pre-committed decision rules for the contract meeting.

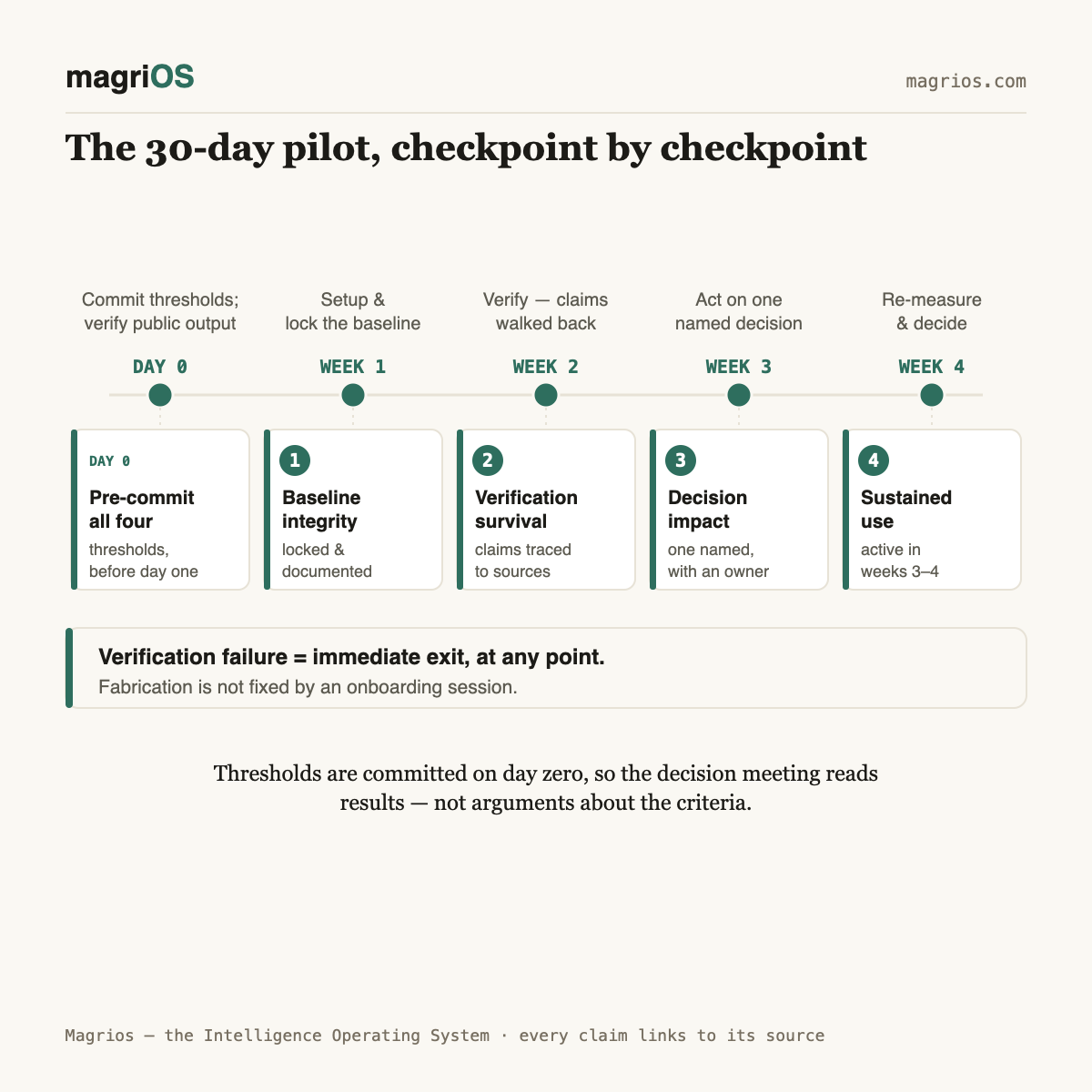

Pilot-to-contract: what a 30-day intelligence-tool pilot must prove — Magrios diagram
A Magrios diagram — every element states a product fact.

A 30-day intelligence-tool pilot must prove four things: the tool's findings survive verification against their sources; at least one finding influenced a real, named decision; the measurement baseline is locked well enough that the next measurement will mean something; and your team was still using the tool in week four. Set the pass thresholds before day one. A pilot without pre-committed criteria is a free trial with a meeting at the end.

What can 30 days actually prove?

Be precise about the pilot's evidentiary limits. Thirty days can prove that findings are verifiable, that the team adopts the tool, that one decision moved, and that a clean baseline exists. It cannot prove long-term trend value — that takes multiple measurement windows and arrives in quarters, not weeks. Design the pilot to prove what it can prove, and contract around what it cannot, rather than pretending a month settled it.

What are the four pass/fail criteria?

CriterionThe testExample threshold — pre-commit your own
Verification survivalSample twenty claims from a pilot report; walk each back to its sourceAt least nineteen survive; any fabricated claim fails the pilot outright
Decision impactOne decision changed, written down, with the finding attachedAt least one, named, with an owner
Baseline integrityBenchmark questions locked and documented before the first measurementThe re-measurement uses the identical set
Sustained useTool sessions in weeks three and four, not only week oneYour team's definition of “still in use,” chosen in advance

The thresholds are examples to pre-commit, not industry norms — the point is that they exist before the pilot generates numbers to argue about. The third row is what makes the fourth week meaningful: the locked benchmark methodology explains why a question set that drifts between measurements cannot show real change.

How should the four weeks run?

Day zero, before the pilot starts. Run the verification exercise on the vendor's existing public output. With Magrios this is possible pre-contract — the sample reports are open, and the evidence explorer lists the source behind every claim — and any vendor that enables a day-zero test has saved you a pilot week. A vendor with nothing real to inspect before the pilot begins is asking the pilot to carry weight it should not.

Week one: setup and baseline. Setup in this category should be fast — Magrios's production scans, for scale, have taken 17 to 48 minutes — so a first week consumed by configuration is diagnostic in itself. Lock the benchmark before the first measurement, and write down where it is documented.

Week two: verification on your own report. Twenty claims, walked back to sources, survival rate recorded.

Week three: act on one finding. Small is fine; named is mandatory. A finding acted on is the only evidence of decision impact that survives the contract meeting.

Week four: re-measure and decide. A weekly research cadence yields four measurement points inside 30 days. The decision meeting reads results against the thresholds committed on day zero — nothing else is on the agenda.

What if the baseline is bad news?

An honest baseline can be low, and a first measurement often is. Magrios measured its own AI visibility at 0/100 with its published method — twice, and recorded the number both times. A pilot that reports weak visibility is not a failed pilot; a pilot that cannot detect weak visibility is. If the tool reports decline during the pilot, that is the measurement working. Tools that only ever report improvement deserve more suspicion, not less.

What can a pilot not prove?

Compounding value: whether the measurement loop still informs decisions in quarter three. Do not buy a multi-year commitment on a 30-day result. Contract at pilot scope and write the renewal criteria now — for example, that the next two measurement windows must each survive the same verification test and inform at least one decision. That converts the unprovable into a scheduled test instead of a leap.

What are the decision rules?

The pre-pilot diligence list — security, provenance, pricing — is in the procurement question set; the pilot is what happens after a vendor survives it.

Frequently asked questions

What should a 30-day pilot prove before contract?

Four things, with thresholds committed before day one: sampled findings survive verification against their sources; at least one named decision changed because of a finding; the measurement baseline is locked and documented; and the team still used the tool in week four. Verification failure overrides everything else — fabrication is not an onboarding issue.

Is 30 days enough to evaluate an intelligence tool?

Enough for verifiability, adoption, baseline quality, and first decision impact — not for long-term trend value, which needs multiple measurement windows. So contract at pilot scope and write renewal criteria that test the trend on schedule, rather than buying a multi-year commitment on one month of evidence.

What if the pilot shows our visibility declining?

A pilot that detects weak or declining visibility is a pilot that worked; the alternative is a tool that cannot see bad news. Judge the pilot on whether the decline is traceable to sources and measured against a locked benchmark. Tools that only ever report improvement deserve more suspicion, not less.
